What Is the Difference Between Hydrostatic and Pneumatic Testing for Pressure Vessels?

Pressure-vessel test records often arrive with the equipment and are filed as part of the manufacturer’s documentation package.

For procurement and project teams, however, the test method deserves more attention than a simple pass-or-fail review.

Hydrostatic and pneumatic testing are not interchangeable procedures. The appropriate method depends on vessel design, service conditions, material, fabrication sequence, site limitations, applicable code, and project-specific requirements.

Choosing or specifying the wrong method can create consequences far beyond the factory test itself — from excessive stored-energy risk during pneumatic testing to contamination, drying problems, additional inspection, rejected documentation, or delayed project handover.

Hydrostatic testing uses a liquid — normally water — to pressurize the vessel, while pneumatic testing uses a compressible gas such as air or nitrogen. Because compressed gas stores substantially more releasable energy than a liquid-filled system at comparable pressure, pneumatic testing requires a different level of procedural control, risk assessment, and personnel protection. Applicable test pressures and procedures must always be determined from the governing code, vessel design conditions, and project specification.

The engineering question is therefore not simply:

Which method is easier?

It is:

Which method provides the required pressure-integrity verification without introducing unacceptable technical or safety risks?

Pharmaceutical vessels, cryogenic equipment, lined vessels, catalyst-service reactors, offshore modules, and equipment whose supporting structure cannot accommodate a full water load may all require special consideration.

In those cases, the justification, test procedure, inspection requirements, and documentation trail become just as important as the test itself.

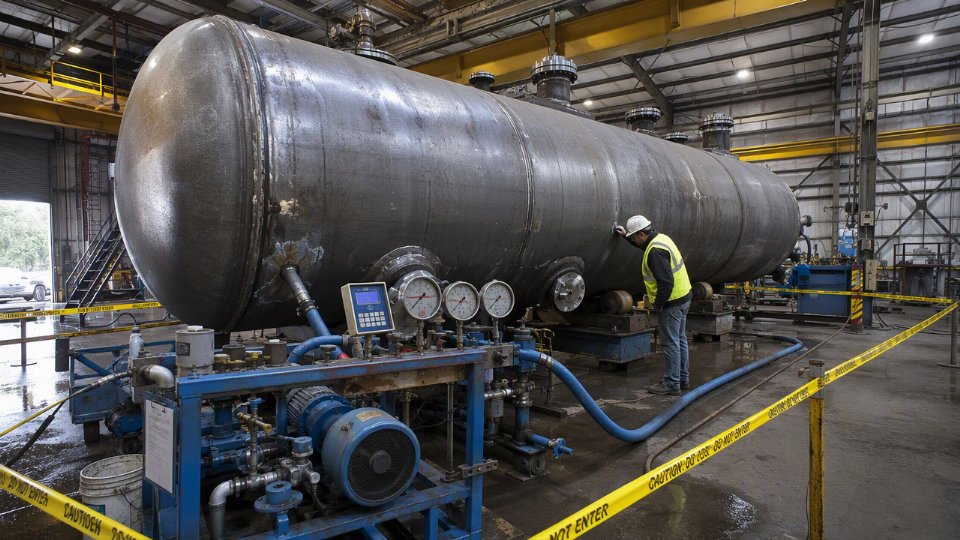

Industrial pressure vessel undergoing hydrostatic testing in a fabrication workshop, with water fill lines and pressure gauges visible

Why Hydrostatic and Pneumatic Tests Have Different Risk Profiles

The most important difference between hydrostatic and pneumatic testing is not the pressure gauge.

It is the amount of energy that can be released if the pressure boundary suddenly fails.

That difference comes primarily from fluid compressibility.

Compressibility: The Physical Divide

Water is treated as nearly incompressible for most pressure-vessel test calculations.

When a water-filled vessel is pressurized, relatively little energy is stored in compression of the liquid itself. If a small defect opens during the test, pressure can fall quickly as water escapes.

The result may be visible leakage, seepage, or local deformation that alerts the inspection team before the condition develops further.

Gas behaves very differently.

Air, nitrogen, and other gases compress substantially under pressure. A pneumatically pressurized vessel therefore contains stored energy that can be released rapidly if the pressure boundary fails.

Rather than simply producing a leak, a sudden rupture may generate a pressure wave and accelerate fragments, fittings, closures, or other components.

This is the fundamental reason pneumatic testing requires tighter controls over pressurization, personnel access, test-area layout, and examination procedures.

Understanding Stored Energy

The exact stored-energy difference between hydrostatic and pneumatic systems depends on vessel volume, pressure, gas properties, temperature, system flexibility, and the assumptions used in the calculation.

The important engineering point is that the difference can be very large.

A gas-filled pressure system may contain orders of magnitude more releasable energy than the same system filled with a nearly incompressible liquid at a comparable pressure.

For large-volume equipment, this difference becomes particularly significant.

A pneumatically pressurized vessel can contain substantially more releasable stored energy than the same vessel hydrostatically tested at comparable pressure because gas is compressible.True

The precise energy ratio depends on pressure, volume, gas properties, system elasticity, temperature, and calculation assumptions. The engineering principle remains the same: compressed gas presents a significantly higher stored-energy hazard than a liquid-filled pressure system.

How Failure Behavior Differs

During a hydrostatic test, a through-wall defect commonly produces visible leakage.

As liquid leaves the system, pressure decreases and the energy available to continue driving the failure also falls.

A pneumatic failure can develop much more rapidly.

If a crack becomes unstable, expansion of the compressed gas can continue supplying energy to the failure. The resulting rupture may therefore be much more violent.

Actual behavior depends on many factors, including:

  • vessel geometry;
  • wall thickness;
  • material toughness;
  • weld condition;
  • temperature;
  • pressure;
  • volume;
  • defect orientation;
  • and restraint conditions.

For this reason, exclusion-zone and test-area planning should be based on the actual equipment rather than a generic distance applied to every vessel.

Why Pressure-Vessel Codes Treat Pneumatic Testing Differently

Major pressure-vessel codes generally distinguish between hydrostatic and pneumatic testing because their hazard profiles are different.

Under ASME Section VIII Division 1, for example, hydrostatic and pneumatic test requirements are addressed separately under UG-99 and UG-100.

Pneumatic testing uses a lower pressure factor than the normal hydrostatic test and requires controlled pressurization.

This does not mean that pneumatic testing is a less rigorous test.

It means that the procedure recognizes the significantly higher consequences associated with compressed-gas energy.

Site safety requirements may go beyond the construction code itself.

Depending on the vessel and project, the test plan may include:

  • remote pressurization;
  • restricted personnel access;
  • engineered exclusion zones;
  • physical barriers;
  • controlled observation positions;
  • emergency depressurization;
  • and defined communication procedures.

Using nitrogen rather than compressed air can address certain process or combustion concerns, but it does not remove the fundamental stored-energy hazard.

The gas remains compressible.

Code Requirements: ASME Section VIII, EN 13445, and GB 150

International EPC projects may involve equipment designed and fabricated under different code systems.

This makes pressure-test requirements particularly important during purchase-order and specification review.

ASME Section VIII, EN 13445, GB 150, purchaser specifications, local regulations, and third-party inspection requirements may not use identical calculation methods or procedural requirements.

Those differences should be resolved before fabrication begins.

ASME Section VIII Division 1: UG-99 and UG-100

Under ASME Section VIII Division 1, UG-99 addresses hydrostatic testing and UG-100 addresses pneumatic testing.

The hydrostatic test requirement is based on MAWP together with the applicable allowable-stress relationship specified by the Code.

For many vessels tested near ambient temperature, the stress ratio may be close to 1.0, but this should not simply be assumed for every material and design temperature.

The test calculation should use the actual applicable stress values.

Pneumatic testing is performed at a lower pressure factor and requires controlled incremental pressurization.

The exact sequence, examination pressure, required inspections, and acceptance criteria should follow the applicable Code edition and the approved manufacturer’s test procedure.

ASME Section VIII Division 1 uses different pressure requirements for hydrostatic testing under UG-99 and pneumatic testing under UG-100.True

The Code treats the two test methods separately because a compressed-gas test presents a different stored-energy hazard from a liquid-filled hydrostatic test. The required pressure should be calculated from the applicable Code provisions rather than from a generic multiplier alone.

EN 13445 Pressure Testing

EN 13445 also recognizes hydraulic testing as the normal pressure-test approach while allowing alternatives under defined conditions.

Where pneumatic testing is proposed, additional engineering justification, risk assessment, examination, and conformity-assessment involvement may be required depending on the equipment category and project requirements.

For equipment supplied under PED, the selected conformity-assessment route and Notified Body involvement should also be considered.

Purchasers should therefore avoid specifying a pneumatic test solely through a single pressure value.

The requirement should identify the governing standard, conformity route, examination scope, test procedure, and required approvals.

GB 150 Pressure Testing

GB 150 likewise contains requirements governing pressure testing of pressure vessels manufactured to the Chinese standard.

The applicable pressure is determined according to the vessel design conditions, test medium, materials, and relevant standard provisions.

Pneumatic testing normally requires additional justification and enhanced safety controls because of the stored-energy risk involved.

For projects subject to Chinese special-equipment supervision, pressure testing should also be coordinated with the applicable inspection and regulatory requirements.

Side-by-Side Comparison

StandardNormal Test ApproachPneumatic Test PositionKey Buyer ConsiderationTypical Documentation
ASME VIII Div.1Hydrostatic testing under UG-99Alternative procedure under UG-100 where applicableVerify correct pressure calculation, procedure, AI involvement, and final recordsTest procedure, test report, pressure record, inspection documentation, MDR-related records
EN 13445 / PED projectsHydraulic testing normally preferredMay require technical justification, risk assessment, and additional conformity controlsConfirm Notified Body and project-specific requirements before fabricationRisk assessment, test certificate, inspection records, conformity documentation
GB 150Hydraulic testing normally usedAlternative subject to applicable technical and safety requirementsCoordinate design, test procedure, and supervision-inspection requirementsTest record, inspection documentation, approvals required by the applicable project

Resolving Code Differences in EPC Projects

When equipment is fabricated under one national code but purchased for a project governed by another regulatory framework or purchaser specification, pressure-test requirements should not be reconciled after the vessel is finished.

The project team should define:

  • governing construction code;
  • applicable code edition;
  • design pressure or MAWP basis;
  • required test method;
  • test-pressure calculation;
  • test medium;
  • inspection involvement;
  • water-quality requirements;
  • and documentation deliverables.

If these requirements are left unresolved, the manufacturer may perform a test that satisfies its own fabrication standard but does not satisfy the purchaser’s project requirement.

Correcting that after shipment can be difficult or impossible.

Shell-and-tube heat exchangers and jacketed vessels require particular attention because multiple pressure chambers may have different design pressures and differential-pressure limitations.

The test sequence must therefore consider not only absolute pressure but also the pressure difference acting across tube sheets, jackets, channels, and internal partitions.

hydrostatic-vs-pneumatic-pressure-vessel-testing-03-code-comparison-asme-en-gb150

When Hydrostatic Testing Should Be the Default

For most conventional pressure vessels, hydrostatic testing remains the preferred pressure-integrity test.

The reason is straightforward: the incompressibility of the test liquid substantially reduces the amount of stored energy available during a failure.

For a typical carbon-steel separator, drum, receiver, storage vessel, or exchanger fabricated in a workshop designed for hydrotesting, a water test is usually straightforward.

Where there is no significant technical reason to avoid it, replacing hydrostatic testing with pneumatic testing simply for convenience should be examined carefully.

Cost or schedule convenience alone should not be treated as sufficient technical justification for selecting a higher-hazard pneumatic test instead of the normal hydrostatic test.True

Selection of a pressure-test method should be based on the applicable construction code, vessel design, process requirements, safety considerations, and documented technical constraints rather than convenience alone.

When Hydrostatic Testing May Become Impractical

There are, however, legitimate engineering situations where a full water test creates its own problems.

Structural or weight limitations.

Large vertical vessels, tall columns, offshore modules, skid-mounted equipment, or installed vessels may impose substantial hydrotest loads on foundations and supporting structures.

Before filling such equipment, the manufacturer or engineer should confirm that the vessel, supports, temporary condition, and surrounding structure can safely carry the full test load.

If they cannot, an alternative test strategy may need to be engineered.

Process contamination or drying limitations.

Certain process systems cannot tolerate residual moisture.

Examples may include some pharmaceutical applications, cryogenic systems, catalyst service, moisture-sensitive processes, and equipment containing narrow internal passages that are difficult to drain and dry.

In these situations, the concern is not merely cleaning inconvenience.

Residual water can interfere with process performance, contaminate the product, freeze at operating temperature, or extend commissioning activities significantly.

Water-sensitive internal materials or service.

Some vessel internals, linings, coatings, catalysts, or future process services may create restrictions on water contact.

The preferred solution is often to sequence the manufacturing process so that hydrostatic testing occurs before the water-sensitive operation.

Where that cannot be done, the alternative test method should be formally justified.

Installed-vessel constraints.

Field-installed equipment may present drainage, water-disposal, structural-load, or accessibility limitations that did not exist in the fabrication shop.

These conditions should be evaluated by engineering rather than treated as automatic justification for pneumatic testing.

Documentation Required When the Normal Hydrostatic Test Is Not Used

Where an alternative test method is selected, the project documentation should clearly explain why.

Depending on the governing code and project requirements, the package may include:

  • written technical justification;
  • engineering approval;
  • approved pressure-test procedure;
  • pressure calculation;
  • risk assessment;
  • personnel exclusion-zone plan;
  • additional NDE requirements;
  • inspector or certifying-body approval;
  • and final test records.

A procurement team should be cautious when a pneumatic test appears on an ITP without a corresponding engineering basis.

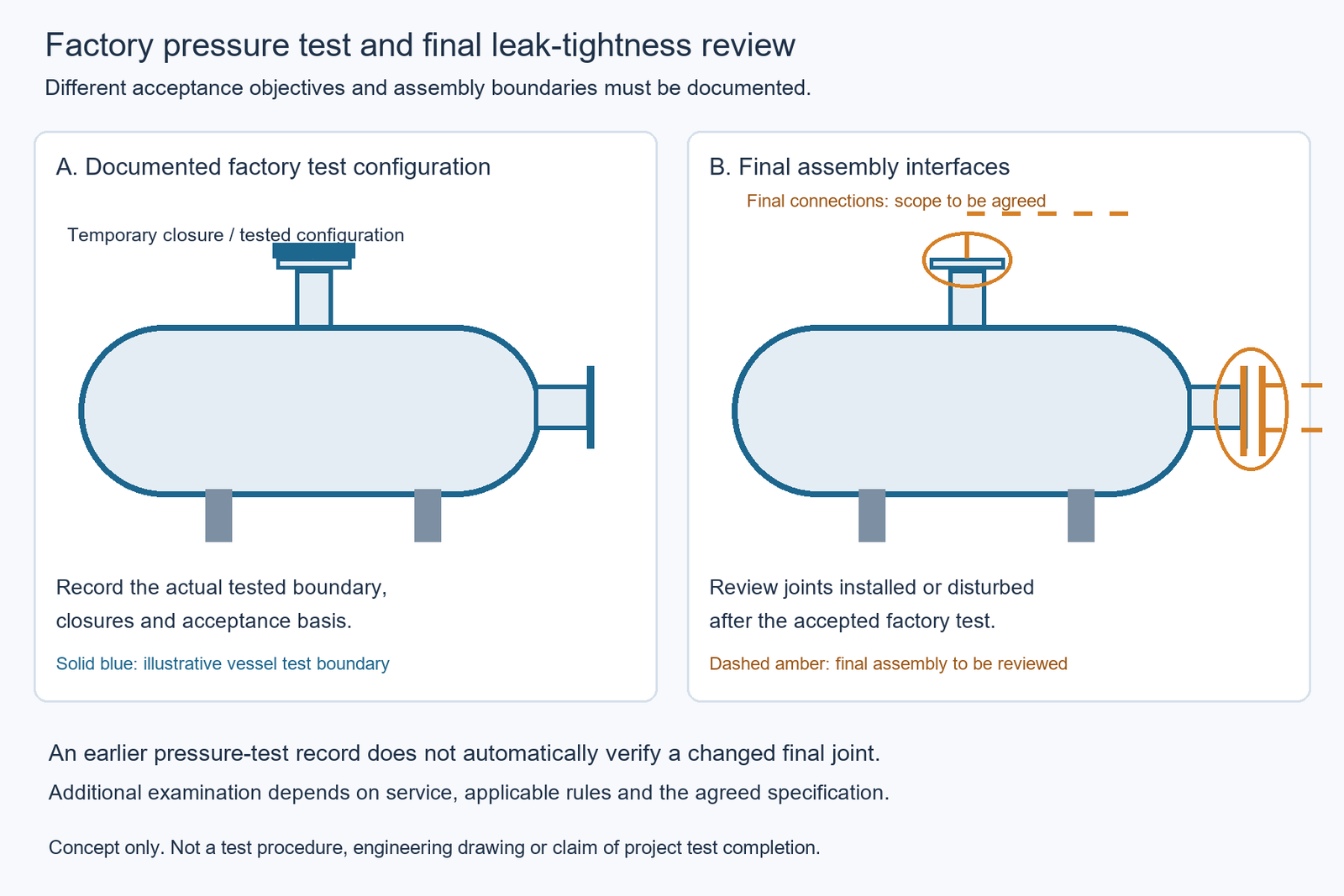

Combining a Hydrostatic Strength Test With a Low-Pressure Leak Test

In many projects, the engineering objectives of pressure testing and leak testing are different.

The hydrostatic test verifies the structural integrity of the pressure boundary.

A separate low-pressure leak test may then be used to check connections that are difficult to evaluate during the water-filled test, such as:

  • threaded fittings;
  • small-bore connections;
  • instrument take-offs;
  • removable closures;
  • flange assemblies;
  • and certain final connections.

This two-stage approach can be useful where both structural proof and final leak-tightness verification are required.

The actual leak-test medium and pressure should be defined in the project specification or approved procedure.

Pneumatic Test Execution: Pressure Control, Personnel Protection, and Leak Examination

Pneumatic testing is not simply hydrostatic testing with water replaced by nitrogen.

The higher stored-energy hazard changes how the entire activity should be planned and executed.

Pre-Test Inspection

Before pneumatic pressurization begins, the vessel should have completed the inspections required by the construction code, approved ITP, and project specification.

The responsible team should confirm that:

  • fabrication is sufficiently complete;
  • required weld examination has been accepted;
  • temporary and permanent closures are suitable;
  • materials and components are correctly identified;
  • pressure-test boundaries are clearly defined;
  • valves and fittings are rated for the test condition;
  • and test instruments are ready and calibrated.

Additional surface or volumetric examination may be required depending on the applicable code and the basis for using pneumatic testing.

The exact scope should be established before the test rather than decided on the shop floor.

Selecting the Test Gas

Nitrogen is frequently selected for pneumatic testing where an inert and dry medium is desirable.

Compressed air may also be used where allowed by the governing procedure and where process, cleanliness, and safety conditions permit.

The decision should consider more than stored energy.

Relevant factors include:

  • oxygen content;
  • contamination;
  • moisture;
  • process compatibility;
  • ignition potential;
  • asphyxiation risk;
  • gas availability;
  • and safe venting.

Nitrogen avoids introducing oxygen and moisture but introduces its own serious asphyxiation hazard, particularly indoors or in poorly ventilated areas.

Gas selection should therefore be part of the formal safety review.

Pressure Ramp Procedure

Pneumatic test pressure should be approached gradually.

The approved procedure should define intermediate pressure stages, stabilization periods, inspection points, final examination pressure, and depressurization sequence according to the governing code.

The purpose of staged pressurization is to detect abnormal behavior before the vessel reaches maximum stored energy.

Personnel should not remain in high-risk areas during active pressurization.

Inspection access should be controlled according to the approved test plan.

hydrostatic-vs-pneumatic-pressure-vessel-testing-01-pneumatic-test-pressure-ramp-sequence-diagram

Pneumatic testing under ASME Section VIII Division 1 uses a different and lower test-pressure requirement than the normal hydrostatic test.True

The Code distinguishes UG-99 hydrostatic testing from UG-100 pneumatic testing because the stored-energy hazards are different. The actual required pressure should be calculated from the applicable Code edition and vessel conditions.

Exclusion Zones and Personnel Access

The exclusion zone for a pneumatic test should be based on a documented risk assessment.

A single generic distance is not appropriate for every vessel because consequences depend on factors such as:

  • vessel volume;
  • test pressure;
  • geometry;
  • material;
  • possible fragment trajectory;
  • test-area construction;
  • closure configuration;
  • and nearby occupied areas.

For higher-risk tests, the plan may include:

  • remote pressure control;
  • remote pressure monitoring;
  • barricades;
  • blast-resistant structures;
  • restricted approach routes;
  • designated observation points;
  • and controlled communication between the test operator and inspector.

The test procedure should clearly state when personnel may approach the vessel and under what conditions.

Leak Detection Methods

Bubble-forming solutions are commonly used for local leak detection during pneumatic examination.

For projects requiring greater sensitivity, alternative methods may include:

  • ultrasonic leak detection;
  • tracer-gas methods;
  • helium mass-spectrometer testing;
  • or other project-specific techniques.

The method should match the required leak-tightness criterion.

A general process vessel does not necessarily require the same leak-detection sensitivity as a vacuum vessel, cryogenic system, or equipment handling a highly sensitive process fluid.

Pressure Relief and Instrumentation

The pneumatic test system should include suitable overpressure protection.

Pressure gauges, recorders, transmitters, relief devices, and related instrumentation used for the test should be appropriate for the required pressure range and supported by valid calibration documentation where applicable.

Instrument identification on the test report should match the calibration certificates.

Where two independent pressure indications are required by the procedure or purchaser specification, both should be installed in suitable locations and visible to the responsible operator.

The pressure-source connection, temporary piping, hoses, fittings, blanks, and closures must also be rated for the test condition.

A pressure vessel is only as safe as the weakest component in the temporary test circuit.

Pneumatic Test Documentation

A complete pneumatic test record should document the actual test rather than merely state that it passed.

Depending on the project, the file may include:

  • vessel identification;
  • approved test procedure;
  • test-pressure calculation;
  • test gas;
  • test date;
  • pressure stages;
  • stabilization or hold periods;
  • instrument serial numbers;
  • calibration certificates;
  • pressure record;
  • leak-examination result;
  • witness information;
  • deviations or NCRs;
  • repair records;
  • and final acceptance.

If leakage or another defect is identified, the repair and subsequent examination should remain traceable through the final manufacturing dossier.

Special Vessel Categories Requiring Additional Test Planning

Some pressure equipment does not fit neatly into a simple hydrostatic-versus-pneumatic decision.

Equipment configuration, lining systems, service requirements, and multiple pressure chambers may significantly affect the test sequence.

Shell-and-Tube Heat Exchangers

A shell-and-tube heat exchanger contains at least two pressure circuits: the shell side and the tube side.

Each side may have its own:

  • design pressure;
  • design temperature;
  • MAWP;
  • material;
  • test pressure;
  • and examination requirement.

Testing one side while the other remains unpressurized creates differential pressure across the tubes and tube sheet.

The test sequence must therefore remain within the differential-pressure limits of the actual design.

This requirement should be addressed explicitly in the manufacturer’s test procedure.

The sequence is also important for detecting tube-to-tubesheet leakage.

Simultaneously pressurizing both sides can reduce or eliminate the differential pressure needed to reveal leakage between the circuits.

Cryogenic Vessels

Cryogenic equipment requires careful consideration of moisture introduction and removal.

Residual water can freeze during low-temperature operation and may affect:

  • valves;
  • small passages;
  • instrumentation;
  • insulation systems;
  • and process cleanliness.

Where a liquid hydrotest is used, complete drainage and drying requirements should be established before the test.

Where a pneumatic or alternative test is selected, the decision should follow the applicable design code and approved engineering procedure.

Helium leak testing may also be specified on vacuum-jacketed or other high-integrity cryogenic equipment where very low leakage rates are required.

It should be understood as a leak-tightness test rather than automatically as a substitute for every required structural pressure test.

Lined and Clad Vessels

For rubber-lined, polymer-lined, glass-lined, or other internally lined equipment, the sequence of pressure testing and lining installation is critical.

Where feasible, pressure testing of the metallic pressure boundary before lining can prevent water from becoming trapped behind a damaged or locally disbonded lining.

After lining installation, the project may specify additional integrity checks such as holiday or spark testing appropriate to the lining system.

The purchase specification should therefore identify the required sequence rather than simply stating “pressure test per code.”

Lethal or Highly Hazardous Service

Vessels intended for lethal or similarly high-consequence service may carry additional construction, examination, and testing requirements.

The exact requirements depend on the governing code and service classification.

Procurement teams should ensure that the designated service appears consistently in:

  • the equipment data sheet;
  • design calculations;
  • drawings;
  • welding requirements;
  • NDE scope;
  • test procedure;
  • and Manufacturer’s Data Report or equivalent certification documents.

Pressure testing for lethal or other highly hazardous service should not be selected solely from a general hydrostatic-versus-pneumatic comparison.True

Such vessels can carry additional construction, examination, testing, and certification requirements under the governing code. The applicable service classification and code provisions must be reviewed directly.

Stainless Steel and Chloride Control

Water quality deserves special attention when hydrostatically testing stainless or other chloride-sensitive materials.

Project specifications may impose maximum chloride limits and may also control:

  • water temperature;
  • contact duration;
  • drainage;
  • flushing;
  • and final drying.

Rather than applying a universal chloride value to every stainless-steel vessel, the permissible limit should follow the applicable material, process requirement, client specification, and test procedure.

The measured water quality should be recorded where required.

API 650 Storage Tanks

Large atmospheric tanks should not automatically be treated as ASME Section VIII pressure vessels.

API 650 tanks are designed and tested under a different framework.

Hydrostatic filling may be used to examine tank integrity and foundation settlement, but this is not equivalent to applying an ASME pressure-vessel test multiplier.

The governing equipment standard should therefore be established before pressure-test language is inserted into a purchase specification.

Inspection Documents Buyers Should Request

The pressure test itself is only one part of the final acceptance package.

For EPC contractors and industrial buyers, the supporting documentation demonstrates:

  • what was manufactured;
  • which materials were used;
  • how the vessel was inspected;
  • which test was performed;
  • who witnessed it;
  • and whether deviations were properly closed.

hydrostatic-vs-pneumatic-pressure-vessel-testing-07-inspection-data-book-document-checklist

Material Test Reports and Mill Certificates

Pressure-retaining materials should remain traceable to the applicable material certificates.

Depending on the component and project requirements, this may include:

  • shell plate;
  • heads;
  • forgings;
  • pipe;
  • nozzles;
  • flanges;
  • bolting;
  • and other pressure-boundary materials.

The heat or lot identification should be consistent between the physical component, material traceability records, and supporting certificate.

Where low-temperature properties or other supplementary requirements apply, the applicable test results should be included in the documentation.

Material certificates are only useful when the certified heat or lot can be traced to the actual pressure-retaining component used in the vessel.True

A complete material traceability system links the original material certification to the component incorporated into the finished pressure vessel.

Dimensional Inspection and As-Built Records

The final dimensional report should document the vessel as actually manufactured.

Depending on the equipment, measurements may include:

  • vessel dimensions;
  • shell and head thickness;
  • nozzle projection;
  • nozzle orientation;
  • flange alignment;
  • support location;
  • overall length or height;
  • internal dimensions;
  • and other project-specific tolerances.

Any accepted deviation should be supported by the applicable concession, engineering disposition, or revised drawing.

For skid-mounted systems and equipment with tight piping-interface tolerances, this information can prevent significant problems during installation.

NDE Records

NDE records should provide complete traceability between the examined location and the final result.

Depending on the method, documentation may include:

  • weld-joint identification;
  • examination procedure;
  • report number;
  • image or film identification;
  • equipment identification;
  • calibration information;
  • examiner qualification;
  • acceptance criteria;
  • findings;
  • and final disposition.

The key buyer question is not simply whether an RT, UT, MT, or PT report exists.

It is whether the report can be traced to the correct physical location on the vessel.

Pressure Test Report

The pressure-test report should identify the essential conditions under which the test was performed.

Typical information includes:

  • vessel number or tag;
  • test medium;
  • calculated required pressure;
  • actual applied pressure;
  • test date;
  • temperature where required;
  • hold or stabilization period;
  • gauge or recorder identification;
  • test-water quality where applicable;
  • examination result;
  • witness;
  • and final disposition.

If leakage or another abnormal condition is identified, the resulting NCR, repair, re-examination, and re-test documentation should also be traceable.

Where the project requires an electronic or charted pressure record, it should be retained with the final test report.

Manufacturer’s Data Report and Compliance Documentation

For ASME-coded vessels, the applicable Manufacturer’s Data Report forms part of the certified vessel documentation.

The report should remain consistent with the final vessel identification, design conditions, materials, NDE, heat treatment, and pressure-test information.

For European projects, the appropriate PED conformity documentation should be included where applicable.

For vessels manufactured under Chinese special-equipment requirements, the applicable manufacturing and supervision-inspection documentation should likewise be included according to the project scope.

Third-Party Inspection Documentation

Third-party inspection requirements should be defined during contract review.

The purchaser should establish:

  • which inspection organization is acceptable;
  • which activities are hold points;
  • which are witness points;
  • which documents require review;
  • and what final certificate or release document is required.

Simply requesting “TPI inspection” without defining the scope can lead to disagreement over whether the inspector was expected to witness the physical test or merely review the final report.

Hydrostatic Test Water Quality Records

Where the vessel material or process service imposes water-quality restrictions, the hydrotest record should include the required supporting evidence.

This may document:

  • water source;
  • chloride concentration;
  • pH;
  • conductivity;
  • temperature;
  • or other project-specific parameters.

The acceptance limits should come from the applicable specification rather than being assumed universally.

Non-Conformance Reports

A closed NCR does not automatically indicate poor manufacturing quality.

Fabrication projects can generate deviations, repairs, and corrective actions.

The important question is whether the issue was:

  1. identified;
  2. documented;
  3. technically evaluated;
  4. corrected;
  5. re-examined;
  6. re-tested where required;
  7. and formally closed.

Missing or unexplained evidence is much more concerning than a properly documented repair history.

For major EPC projects, the final data-book review can be established as a contractual hold point before shipment or final payment release.

Common Specification Errors and Red Flags

Many pressure-test problems begin before the vessel reaches the test bay.

They begin in the purchase specification, ITP, or document-review process.

Pneumatic Testing Listed Without an Engineering Basis

If a supplier proposes pneumatic testing, the project team should understand why.

The answer should come from the applicable engineering and code basis rather than from convenience alone.

The purchaser should request the corresponding:

  • technical justification;
  • approved procedure;
  • risk assessment;
  • NDE requirements;
  • safety controls;
  • and required inspection approvals.

A pneumatic test appearing in an ITP with no supporting basis deserves further review.

Test Pressure Does Not Match the Approved Design Basis

The pressure recorded on the test report should be checked against:

  • the approved data sheet;
  • final design conditions;
  • applicable MAWP where relevant;
  • pressure-test calculation;
  • drawing revision;
  • and applicable construction code.

A mismatch may indicate something as simple as a document-transcription error.

It may also indicate that the design changed after testing or that an incorrect pressure was used.

Either way, it should be resolved before final acceptance.

Unexplained Pressure Change During the Hold Period

Pressure does not always remain mathematically constant during a test.

Temperature variation, stabilization, instrumentation behavior, and other factors can influence the recorded value.

However, any meaningful anomaly in the pressure record should be investigated and documented.

The final written report and underlying pressure record should tell the same story.

Pressure Test Performed Before Fabrication Is Complete

The project team should verify that all pressure-boundary fabrication required to be covered by the test has been completed before the final pressure test.

Late additions such as instrument nozzles, couplings, or pressure-boundary attachments may require engineering review and additional testing or examination.

The fabrication sequence, weld map, nozzle schedule, ITP, and test date should therefore be consistent.

Incorrect Heat-Exchanger Test Sequence

Heat exchangers require independent consideration of shell-side and tube-side pressures.

Testing both circuits simultaneously can mask leakage between them.

Conversely, pressurizing one side against an unpressurized opposite side may impose differential loads that must be checked against the design.

The approved test procedure should clearly define the sequence.

Hydrotest Water Quality Not Defined for Stainless Steel

For chloride-sensitive materials, the purchaser should define the required water-quality criteria before testing.

Waiting until the test is complete to ask for chloride analysis creates an avoidable documentation problem.

The requirement should also specify appropriate drainage and drying where needed.

Water quality should be controlled during hydrostatic testing when vessel material or process service is sensitive to chloride or other contaminants.True

The applicable limits depend on material grade, service, temperature, contact duration, governing specification, and project requirements. A universal chloride threshold should not be applied without reviewing those conditions.

Purchase Order Does Not Clearly State the Governing Code

A pressure-vessel purchase specification should identify the required construction code and applicable edition.

Writing only “ASME vessel” or “pressure vessel standard” can leave important details unresolved.

The data sheet should also define the required test method and project-specific additions where applicable.

This establishes a common basis for the manufacturer, purchaser, EPC contractor, and third-party inspector.

ITP Approved Too Late

One of the most useful procurement controls is to require approval of the Inspection and Test Plan before critical fabrication activities begin.

The ITP can define:

  • material inspection;
  • welding hold points;
  • NDE;
  • PWHT;
  • dimensional inspection;
  • pressure testing;
  • coating inspection;
  • purchaser witness points;
  • third-party inspection;
  • and final document review.

Approving the ITP only after fabrication is substantially complete removes much of its value.

Frequently Asked Questions About Hydrostatic and Pneumatic Testing

Can a vessel that fails a hydrostatic test be repaired and retested?

Potentially, yes.

Pressure-vessel codes and quality systems provide mechanisms for evaluating and repairing certain fabrication defects.

The exact repair route depends on the defect, material, vessel condition, applicable construction code, manufacturer’s quality system, and inspection authority.

A typical repair process may include:

  • NCR issuance;
  • engineering disposition;
  • approved repair procedure;
  • qualified welder;
  • applicable preheat or PWHT;
  • NDE after repair;
  • and pressure re-testing where required.

The complete repair history should remain in the manufacturing documentation.

Repeated defects at the same location warrant more detailed engineering investigation rather than simply repeating the same repair indefinitely.

Is pneumatic testing less reliable than hydrostatic testing?

The two methods should not be compared simply as “more reliable” or “less reliable.”

They create different inspection conditions and different risks.

Hydrostatic testing provides the important safety advantage of low stored energy and can make small liquid leakage visually obvious.

Pneumatic testing may provide useful leak-detection sensitivity when combined with bubble, acoustic, or tracer-gas techniques, but it carries significantly greater stored-energy consequences.

For this reason, pneumatic testing relies heavily on appropriate pre-test examination and controlled execution.

Pneumatic testing carries a substantially higher stored-energy hazard than hydrostatic testing because the gas is compressible.True

This physical difference is the central reason pneumatic pressure testing requires more stringent risk controls, staged pressurization, personnel protection, and test planning.

What hydrostatic test pressure applies to a vessel with a 10 bar MAWP under ASME Section VIII Division 1?

The value should be calculated using the requirements of the applicable Code edition rather than assuming a simple multiplier.

The hydrostatic test calculation under ASME Section VIII Division 1 considers MAWP together with the applicable allowable-stress relationship between test and design conditions.

If the relevant allowable-stress ratio equals 1.0, a simplified example based on a 1.3 factor would produce 13 bar.

However, where the stress ratio differs from 1.0, the required value will also differ.

The manufacturer’s formal test-pressure calculation should therefore be reviewed rather than relying on a generic example.

Can the hydrostatic test also serve as the final leak test?

Not necessarily.

A hydrostatic pressure test primarily demonstrates the integrity of the pressure boundary under the required test condition.

Some final connections may be installed or disturbed after the shop pressure test.

Depending on the project, an additional leak-tightness test may therefore be required for:

  • flange joints;
  • instrument connections;
  • threaded fittings;
  • valve packing;
  • field connections;
  • or other completed assemblies.

The purchase specification should distinguish between the required structural pressure test and any separate leak test.

Who witnesses the pressure test?

Witness requirements depend on the governing code, conformity-assessment route, jurisdiction, purchaser specification, and agreed ITP.

For an ASME-coded vessel, the Authorized Inspector has defined inspection responsibilities under the manufacturer’s ASME quality-control system.

PED projects may involve a Notified Body depending on the conformity-assessment procedure.

Chinese-regulated equipment may require involvement of the applicable supervision-inspection organization.

The purchaser should confirm the required witness organization and hold points during contract review.

Does the pressure-test value appear on the vessel nameplate?

The vessel nameplate normally focuses on certified equipment identification and design information required by the applicable construction code.

The pressure-test details are generally retained in the manufacturing and inspection records rather than being treated as the primary operating information on the nameplate.

For historical verification, the owner should therefore consult the final data book or Manufacturer’s Data Report rather than relying only on the physical nameplate.

What happens if the wrong pressure-test method is used?

The consequence depends on the governing code, vessel design, project requirements, and the nature of the deviation.

The issue may require:

  • engineering evaluation;
  • Authorized Inspector or conformity-body review;
  • additional NDE;
  • repeat testing;
  • formal deviation approval;
  • or other corrective action.

The test should not simply be accepted because the vessel happened to survive it.

Pressure testing is a controlled part of the certification process, so both the physical result and the approved procedure matter.

The most effective way to avoid this problem is to agree the test method, governing code, pressure calculation, test medium, inspection scope, and witness requirements before fabrication reaches the final test stage.

hydrostatic-vs-pneumatic-pressure-vessel-testing-08-faq-test-pressure-nameplate-vs-mdr-comparison

Final Takeaway: Specify the Test Method Before Fabrication, Not Before Shipment

For most conventional pressure vessels, hydrostatic testing remains the logical starting point because it provides pressure-integrity verification with significantly lower stored-energy risk.

Pneumatic testing has an important role where water introduces a genuine technical problem, but it should be treated as an engineered test method rather than a convenient substitute.

For procurement teams, EPC contractors, inspectors, and manufacturers, the most important controls happen before the test itself:

define the governing code, confirm the design conditions, agree the test method, calculate the correct pressure, identify water-quality or process restrictions, approve the ITP, establish witness requirements, and define the final documentation package.

When those decisions are made early, pressure testing becomes what it should be — a controlled final verification of vessel integrity rather than a last-minute source of technical disagreement, safety risk, or shipment delay.

    Picture of Banks Zheng

    Banks Zheng

    Engineer | Pressure Vessel Project Manager

    20+ years of experience in pressure vessels, including storage tanks, heat exchangers, and reactors. Managed 100+ oil & gas projects, including EPC contracts, across 20+ countries. Industry expertise spans nuclear, petrochemical, metallurgy, coal chemical, and fertilizer sectors.

    Get a Free Quote

    Recent Blogs

    contact us now

    Have a question, need a quote, or want to discuss your project? We’re here to help.
    Don’t worry, we hate spam too!  We’ll use your info only to reply to your request.
